Prime vs Sub in Government Contracting: Complete Guide for March 2026

The prime versus subcontractor decision shapes your entire federal contracting strategy. It affects your relationship with the agency, your payment structure, your compliance workload, and your liability exposure. Whether you're entering the federal market for the first time or expanding into new agencies, knowing when to prime and when to sub can accelerate your growth without overextending your team. This guide covers the key differences, regulatory requirements, and strategic considerations that determine which role makes sense for your business.

TL;DR

  • Primes hold direct contracts with agencies and manage full compliance; subs work under primes with limited scope and lower risk.

  • Federal rules require primes to self-perform at least 50% of service work (15% for construction) to prevent pass-through arrangements.

  • Primes face full liability for subcontractor failures, delays, and compliance violations under their contract.

  • Subcontracting builds federal past performance and agency relationships without full contract management burden.

  • GovDash Contract tracks prime and sub roles across contracts to surface relevant past performance for proposals.

What Is a Prime Contractor in Government Contracting

A prime contractor holds the direct contractual relationship with the federal government agency. When you win a federal contract as the prime, you own the entire scope of work and serve as the sole point of contact for the agency throughout the project lifecycle.

Primes carry full responsibility for delivering on every requirement in the contract, whether they perform the work themselves or bring in subcontractors to handle portions of it. This includes meeting all technical specifications, compliance obligations, delivery schedules, and reporting requirements outlined in the agreement.

Managing a federal contract as a prime requires systems like GovDash Contract that can handle complex administrative and financial demands. You need to track contract performance, manage invoicing and payments, maintain compliance with Federal Acquisition Regulation clauses, and document all deliverables. If you use subcontractors, you remain accountable to the government for their performance, quality, and compliance.

What Is a Subcontractor in Government Contracting

A subcontractor works under a prime contractor instead of directly with the government agency. Your contract is with the prime, not the federal buyer. The prime manages your scope, deliverables, payment terms, and performance expectations.

Subcontractors typically bring specialized capabilities that complement the prime's offerings. You might handle a specific technical task, provide niche expertise, or deliver components that feed into the larger project. This arrangement lets you focus on what you do best while the prime handles agency coordination and contract administration.

For companies new to federal work, subcontracting offers a lower-risk entry point. You can build federal past performance, learn government compliance requirements, and develop agency relationships without taking on full prime contractor responsibilities. Many successful primes started by subcontracting first, using those projects to prove their capabilities and qualify for larger opportunities later, sometimes formalizing partnerships through a teaming agreement.

Key Differences Between Prime and Subcontractor Roles

The relationship you have with the government, your payment flow, and your daily responsibilities look very different depending on whether you're the prime or a sub.

A clean, professional diagram showing the federal government contracting relationship structure. At the top, a government building representing the federal agency. In the middle, a primary business office building representing the prime contractor, connected to the government with a direct line labeled with a handshake icon. Below the prime contractor, two smaller office buildings representing subcontractors, connected to the prime contractor with lines. The diagram uses a blue and gray color scheme with simple geometric shapes, showing a clear hierarchical flow from government to prime to subcontractors. Modern, minimal illustration style with no text or letters.

Factor

Prime Contractor

Subcontractor

Contract Relationship

Direct agreement with federal agency

Agreement with prime contractor

Payment Source

Federal government pays directly

Prime contractor pays you

Agency Interaction

Primary point of contact for all communications

Limited or no direct agency contact

Scope Ownership

Owns entire contract scope and deliverables

Owns specific work package or task area

Project Coordination

Manages all subcontractors and agency reporting

Coordinates with prime, not agency

Risk Exposure

Full contract performance and compliance liability

Limited to your defined scope and terms

If you're building federal credentials or lack the infrastructure to manage complex agency requirements, subcontracting lets you participate in government work while the prime handles administrative burden. If you have the team, systems, and past performance to manage agency relationships directly, priming gives you full control and higher revenue potential.

Federal Requirements for Prime Contractors and Subcontractors

Prime contractors must register in the System for Award Management (SAM.gov) before receiving any federal award. Subcontractors aren't required to register unless the subcontract includes that requirement or they plan to pursue prime contracts later.

Large primes awarded contracts exceeding $750,000 ($1.5 million for construction) must submit a subcontracting plan creating maximum practicable opportunities for small businesses. Plans include percentage goals for small business, veteran-owned small business, service-disabled veteran-owned small business, HUBZone, and small disadvantaged business participation. Primes report actual subcontracting dollars semi-annually through eSRS (Electronic Subcontracting Reporting System).

Federal policy protects subcontractors by requiring primes to meet subcontracting commitments. Agencies may reduce past performance ratings or take corrective action when primes fail to meet goals.

Limitations on Subcontracting and Self-Performance Rules

Federal regulations require prime contractors to perform a minimum percentage of work to prevent pass-through arrangements where primes win contracts but perform little actual work.

For service contracts, primes cannot pay more than 50% of the contract amount to subcontractors that are not similarly situated entities. If your small business prime uses another small business sub in the same socioeconomic category, that work doesn't count toward your 50% limit. Any work that similarly situated sub further subcontracts does count against your cap.

Construction contracts follow different thresholds. General construction primes cannot subcontract more than 85% of the work, while special trade contractors face a 75% subcontracting limit.

Similarly situated entities share the same small business designation as the prime, such as 8(a), SDVOSB, WOSB, or HUBZone certified firms. If you're a service-disabled veteran-owned small business (SDVOSB) prime and team with another SDVOSB sub, their work doesn't trigger the limitations on subcontracting clause. This encourages legitimate teaming among qualified small businesses.

Track your subcontracting percentages carefully. Violating these requirements can result in contract termination, suspension from federal contracting, or False Claims Act liability.

Prime Contractor Liability for Subcontractor Performance

When you sign a federal contract as the prime, you accept full responsibility for every deliverable and requirement, even if a subcontractor performs the actual work. The government holds you accountable for subcontractor failures, delays, or compliance violations as if you had caused them yourself.

This liability cannot be transferred or waived through your subcontract agreements. If your sub misses a deadline, delivers poor quality work, or violates a FAR clause, the contracting officer looks to you for resolution. You may face corrective action plans, withheld payments, negative past performance ratings, or contract termination based on subcontractor problems.

For primes, subcontractor vetting and oversight are critical. Verify capabilities, check past performance, review financial stability, and build strong subcontract terms before award. Monitor performance throughout the contract and resolve issues immediately.

For subs, recognize that your performance directly affects your prime's reputation and contract standing. Missed commitments can damage the prime's relationship with the agency and eliminate future teaming opportunities with that partner.

How Subcontracting Provides an Entry Path to Federal Contracting

Subcontracting lets new federal contractors build credibility without full contract management burden. You gain past performance, learn FAR compliance, and develop agency exposure while an experienced prime handles administration and reporting.

Recent regulatory changes allow small businesses to receive past performance credit for first-tier subcontract work, making the jump to prime status more realistic. This credit appears in systems like CPARS (Contractor Performance Assessment Reporting System), giving you documented proof of successful contract delivery. Primes also share their security clearances, certifications, and agency relationships, which would take years to develop independently. Starting as a sub cuts your ramp-up time from 18+ months to under six.

Deciding Between Priming and Subcontracting for Your Business

Choosing between prime and subcontracting roles depends on your company's current position and growth objectives.

Consider priming when you have documented past performance in the relevant domain, proposal resources to handle RFP responses, and administrative infrastructure to manage compliance reporting and agency communications. You'll need financial reserves to cover cash flow gaps, since federal payment cycles can stretch 30-60 days after invoice submission.

Subcontracting makes more sense when you lack past performance in a particular agency or contract type, need to learn new compliance requirements, or want to expand into adjacent technical areas without shouldering full contract risk. It works when your team is too small to manage both business development and contract delivery simultaneously.

Most successful federal contractors run a hybrid strategy, priming on contracts aligned with their core strengths while subcontracting to enter new agencies, build credentials in new capability areas, or access opportunities beyond their current contract ceiling limits.

Managing Prime-Sub Relationships in GovDash Contract Management System

Contract Cloud gives you complete visibility into both your prime and subcontracting work, centralizing every contract award with its full documentation. The system automatically tags each contract by your role, tracking whether you performed as prime or sub on every project.

This tracking becomes critical during proposal development. When building a new bid, you need past performance examples that match your proposed role. If you're priming a contract, Contract Cloud surfaces projects where you successfully managed subcontractors, demonstrated compliance oversight, and coordinated with agencies. If you're bidding as a sub, it pulls your relevant subcontract deliveries that prove your technical capabilities without requiring prime contract experience.

For active contracts, GovDash Contract helps primes monitor subcontractor performance against milestones and deliverables. You can generate status reports showing both your direct contributions and sub performance, creating the documentation agencies expect during contract reviews and CPARS evaluations.

The system also tracks your teaming relationships over time. You can quickly identify which subcontractors you've successfully worked with on past contracts, making it easier to assemble proven teams for new opportunities. This history helps you vet potential subs by seeing their actual performance on your previous projects.

When you're evaluating whether to prime or sub on a new opportunity, GovDash Contract's capability analysis compares the solicitation requirements against your documented past performance in both roles. This data-driven view shows you where you have the credentials to prime versus opportunities where subcontracting makes more strategic sense.

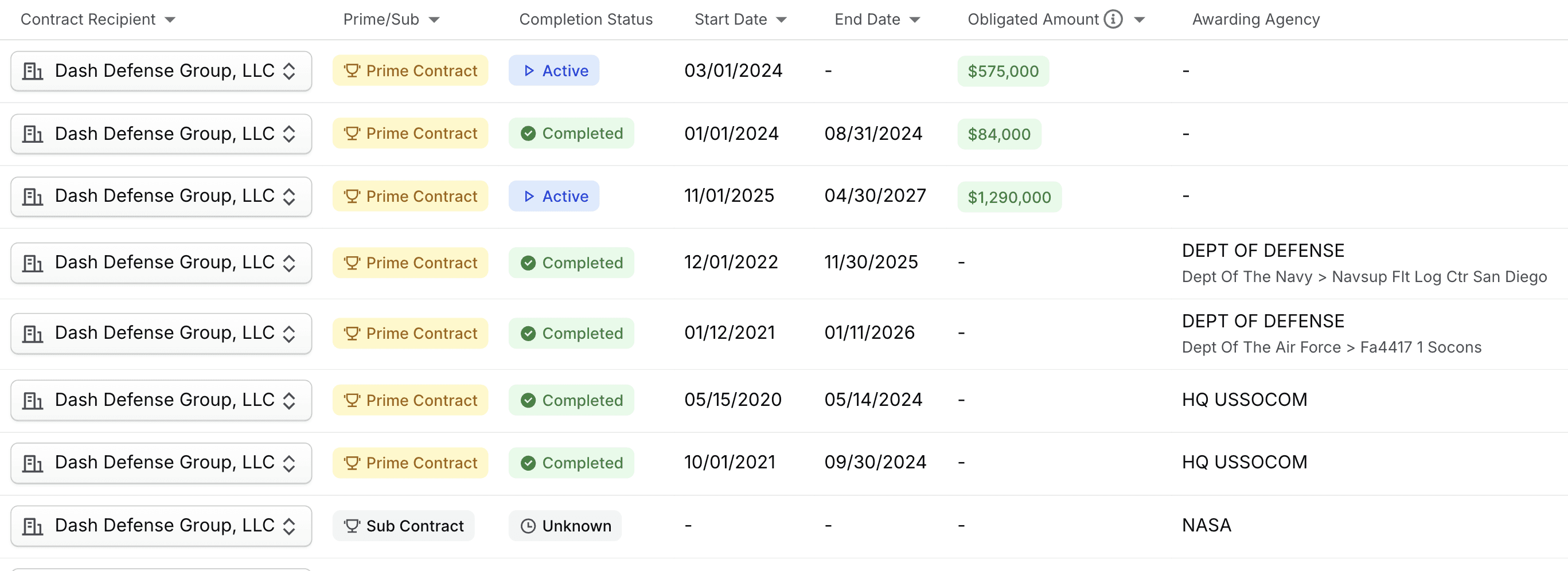

Screenshot 2026-03-23 at 11.33.22 AM.png

Final Thoughts on Federal Prime and Sub Relationships

Knowing when to prime versus sub prime vs prime opportunities keeps your pipeline healthy and your team focused. Most contractors shift between roles based on contract type, agency familiarity, and current capacity. Focus on building credentials that support whichever path aligns with your next milestone.

FAQs

What percentage of work must a prime contractor perform on a federal contract?

For service contracts, primes must perform at least 50% of the work themselves or through similarly situated small businesses. General construction contracts require primes to perform at least 15% of the work, while special trade construction contracts require 25% minimum self-performance.

Can subcontractors receive past performance credit for federal work?

Yes. Recent regulatory changes allow small businesses to receive past performance credit for first-tier subcontract work, which appears in systems like CPARS (Contractor Performance Assessment Reporting System). This makes it easier for subs to build credentials and eventually compete for prime contracts.

Who is liable if a subcontractor fails to meet contract requirements?

The prime contractor holds full liability for subcontractor performance. If your sub misses deadlines, delivers poor quality work, or violates compliance requirements, the contracting officer holds you accountable as if you caused the problem yourself. This liability cannot be transferred through subcontract agreements.

Do subcontractors need to register in SAM.gov?

No. Subcontractors are not required to register in SAM.gov unless their specific subcontract includes that requirement or they plan to pursue prime contracts in the future. Only prime contractors must be registered in SAM.gov before receiving a federal award.

When should a company choose to prime versus subcontract on a federal opportunity?

Prime when you have documented past performance, proposal resources, compliance infrastructure, and financial reserves to handle 30-60 day payment cycles. Subcontract when you lack past performance with a specific agency, need to learn new compliance requirements, or want to expand capabilities without full contract risk.

Stay Ahead in Federal Contracting with the GovDash Monthly Intel Brief

Your trusted, all-encompassing source for the intel that drives results.

A curated overview of platform updates, data features, and use cases from across the public sector.

Less expensive than a lost bid

Submit the form to schedule your GovDash tour and get your custom quote started.

By clicking "Submit," you agree to the use of your data in accordance

with GovDash’s Privacy Notice, including for marketing purposes.

© 2026 All Rights Reserved. Made in America 🇺🇸

Less expensive than a lost bid

Submit the form to schedule your GovDash tour and get your custom quote started.

By clicking "Submit," you agree to the use of your data in accordance

with GovDash’s Privacy Notice, including for marketing purposes.

© 2026 All Rights Reserved. Made in America 🇺🇸

Less expensive than a lost bid

Submit the form to schedule your GovDash tour and get your custom quote started.

By clicking "Submit," you agree to the use of your data in accordance

with GovDash’s Privacy Notice, including for marketing purposes.

© 2026 All Rights Reserved. Made in America 🇺🇸
